Failure Mode Analysis: Guide to Quality & Safety

A line can look stable for weeks, then stop cold because one sensor bracket slipped, one feeder started presenting parts inconsistently, or one operator bypassed a check to keep output moving. The downtime shows up immediately. The quality problem often shows up later, after suspect product has already moved downstream.

That's where failure mode analysis stops being theory and starts being operational discipline. In semi-automated manufacturing especially, the biggest problems usually don't come from dramatic breakdowns. They come from small, predictable weaknesses that nobody forced into the open early enough.

If you're responsible for throughput, labor efficiency, validation readiness, or automation ROI, Failure Mode and Effects Analysis (FMEA) is one of the most practical tools available. Used well, it helps you prevent downtime, protect quality, and make better decisions about where automation provides a return.

Table of Contents

Why Proactive Failure Planning Is No Longer Optional

A new semi-automated cell usually gets approved because the business wants higher throughput, better repeatability, or less dependence on manual labor. Then the line goes live and reality arrives. A sensor starts false-triggering, a gripper doesn't tolerate part variation, or a work instruction leaves too much room for interpretation. The hardware may be sound, but the process still fails.

That's why failure mode analysis matters. It shifts the team from reacting to breakdowns after launch to asking the harder question before launch: How can this process fail, what happens if it does, and what controls are in place to stop it?

A halted robotic arm standing over an industrial conveyor belt inside a clean manufacturing facility.

FMEA belongs at the front end

FMEA has been used for decades across manufacturing and other high-reliability environments to evaluate safety and reliability, with roots going back to military and reliability engineering work in the mid-20th century, as summarized in this history of Failure Mode and Effects Analysis. The reason it has lasted is simple. It forces teams to identify and prioritize failure before those failures become scrap, downtime, customer complaints, or validation findings.

Manufacturing teams should treat FMEA as a trigger-based activity, not an annual quality exercise. It's formally used when designing a new product or process, planning changes to an existing process, pursuing a quality improvement goal, or taking corrective action on a known failure. The same source notes that building prevention in early matters because waste and rework can escalate by 15 to 30% when problems are handled after production instead of before it starts, according to Rockwell Automation's FMEA guidance.

Practical rule: If a project includes new tooling, new controls, new operators, new materials, or new quality requirements, it already has enough uncertainty to justify an FMEA.

This matters even more in regulated environments. If you're building or upgrading a line for medical device production, process risk thinking has to sit alongside documentation, validation, and control strategy. That's part of why teams working in regulated plants often tie FMEA work to broader GMP manufacturing requirements, not just maintenance or quality records.

It protects automation investments

Semi-automation sits in an awkward middle ground. It's flexible, cost-effective, and often the right fit for small to mid-sized manufacturers. It also creates interfaces where failures hide. A manual load step feeds an automated press. A vision check depends on part orientation. A PLC sequence assumes timing consistency that real operators and real materials don't always deliver.

Those are exactly the conditions where proactive analysis pays off.

A good FMEA does three things for operations managers:

  • It exposes weak assumptions before they become line stoppages.
  • It gives risk a common language so production, maintenance, quality, and engineering stop arguing from gut feel.
  • It supports smarter capital decisions by showing where a fixture, sensor, poka-yoke, or controls upgrade reduces meaningful risk.

The companies that get value from automation aren't the ones that avoid every failure. They're the ones that identify likely failures early enough to design around them.

Without that discipline, teams tend to overbuy equipment in some areas and under-control critical risk in others. That's expensive both ways.

Building the Right Team and Setting Clear Boundaries

A weak FMEA usually doesn't fail because the form is wrong. It fails because the wrong people filled it out, or because the team tried to analyze too much at once.

One quality engineer working alone can complete a worksheet. That doesn't mean the analysis is useful. The best failure mode analysis sessions pull in the people who know how the line behaves when production pressure is real.

Who needs to be in the room

For most manufacturing projects, the minimum useful team includes production, maintenance, quality, and engineering. If the process is operator-dependent, include an experienced operator. If the cell includes custom tooling, vision, robotics, or validation requirements, bring in the people responsible for those areas too.

That cross-functional input matters because incomplete failure mode identification is a common problem. One cited review notes that it appears in approximately 40% of initial analyses when teams don't use cross-functional brainstorming, according to PTC's discussion of FMEA pitfalls.

A practical team often looks like this:

  • Production lead: knows where cycle variation, awkward handling, and real-world workarounds appear.
  • Maintenance technician: sees recurring wear points, sensor fouling, loose connections, and access issues.
  • Quality engineer: defines critical-to-quality risks, inspection gaps, and documentation needs.
  • Controls or design engineer: understands logic, sequencing, hardware assumptions, and machine limitations.
  • Operator or setup technician: catches usability failures that engineers regularly miss.

Scope is where most teams either win or waste time

The second mistake is scoping the analysis too broadly. Don't start with “the whole department” or “the full assembly line” unless the line is simple enough to handle that level of review. Narrowing the boundary to one machine, one station, one transfer step, or one process family often yields better results.

Use a short scoping checklist before the first meeting:

  1. Define the item being analyzed. A screwdriving cell is a scope. “Final assembly” usually isn't.
  2. Set start and end points. Include exactly where material enters and where accepted output exits.
  3. List assumptions. Operator loading, air supply, incoming material condition, and upstream timing all affect the analysis.
  4. Separate design risk from process risk. Don't mix equipment design questions with operator method issues if they need different owners.

A broad FMEA gives you a long spreadsheet. A bounded FMEA gives you decisions.

DFMEA and PFMEA solve different problems

This distinction matters in automation projects.

Design FMEA (DFMEA) is used when the team is evaluating the design itself. That includes custom fixtures, grippers, nests, mechanical tolerances, controls architecture, guarding concepts, or part presentation methods before the equipment is finalized.

Process FMEA (PFMEA) is used when the process already exists or is close to launch, and the team needs to assess how the operation can fail during setup, running, inspection, handoff, cleaning, maintenance, or changeover.

If you're buying or building new equipment, both may be needed. DFMEA helps prevent building the wrong machine. PFMEA helps prevent running the machine the wrong way.

How to Use the FMEA Worksheet and Score Risk

A line goes down at 2:13 a.m. The maintenance log says “intermittent torque fault,” production says the screwdriver is fine, and quality is sorting parts because some assemblies passed the station without meeting spec. That is the point where a weak FMEA shows up. If the worksheet only exists to satisfy an audit, it will not help the team find the failure path fast enough to prevent repeat downtime.

A useful worksheet does one job well. It forces the team to describe how a station fails, what that failure causes, why it happens, and which current controls work on the floor.

Start with a real station. A semi-automated screwdriving cell is a good example because it mixes equipment behavior, operator interaction, part variation, and inspection logic. That mix is exactly where many automation projects struggle, especially when the plant does not have years of clean historical data.

Build the worksheet around one function

Use one clear function such as drive screw to required torque.

Then document the failure chain in order:

  1. Failure mode: screw not driven to torque
  2. Effect: loose assembly, downstream failure, customer complaint, or field reliability risk
  3. Cause: worn bit, low air pressure, stripped screw head, wrong recipe, bad part presentation, or part not seated in the nest

The order matters. Teams in launch mode often jump straight to causes because they want to fix something quickly. That usually creates noise. If the group has not agreed on the failure mode and effect first, the scoring gets inconsistent and the action list gets bloated.

For semi-automated equipment, this discipline matters even more because one symptom can come from several sources. A torque fault may be a tooling issue, a feeder issue, an operator loading issue, or a control logic issue. The worksheet helps separate those paths before money gets spent on the wrong countermeasure.

Fill out the columns in the way the station actually operates

A basic FMEA worksheet has standard fields, but the best teams translate them into shop-floor language instead of quality jargon.

Worksheet Field What to capture in plain language
Process step or function What the station must do
Potential failure mode How that step can fail
Potential effect of failure What happens if it fails
Severity How serious the effect is
Potential cause Why the failure could happen
Occurrence How likely the cause is
Current controls What prevents or detects the issue now
Detection How likely current controls are to catch it
RPN or action priority Which issues need action first
Recommended action What the team will change
Owner and follow-up Who closes the action and verifies it

On the floor, “current controls” is where weak analysis usually shows up. Teams list operator attention, training, or a generic alarm as if those controls are equally reliable. They are not. A poka-yoke hard stop, a torque transducer with reject logic, and an HMI message all reduce risk differently. If your team needs a broader machine review before scoring station failures, a formal automation risk assessment for semi-automated equipment helps define where safety hazards, quality risks, and process failures overlap.

Treat the worksheet as an operating document. It should help production, maintenance, engineering, and quality make the same decision from the same facts.

Score risk for decision-making, not false precision

RPN is still a practical starting point for many operations teams. The usual method multiplies three ratings. Severity, Occurrence, and Detection. Each is scored on a 1 to 10 scale, producing a Risk Priority Number that helps rank where action is needed first, as described in Control.com's FMEA article for industrial automation.

The math is simple. The judgment is harder.

The goal is not perfect agreement on whether a risk is a 6 or a 7. The goal is to score consistently enough that the team can decide where to spend engineering time, maintenance effort, and capital. In semi-automated systems, that is a real trade-off. Plants rarely have the budget to redesign every weak point at once.

Here is a practical scoring guide that works well for production teams.

FMEA Scoring Guide (Example Scale)

Rating Severity of Effect (S) Likelihood of Occurrence (O) Likelihood of Detection (D)
1 to 3 Minor effect, little impact on function or quality Uncommon based on current process knowledge Very likely to be detected before release
4 to 6 Noticeable impact on performance, rework, or line flow Happens occasionally or under known conditions Detection exists, but gaps remain
7 to 8 Major effect on product function, sustained downtime, or likely nonconformance Repeats under realistic operating conditions Detection is weak, late, or operator-dependent
9 to 10 Safety, compliance, or severe customer-impact risk Highly likely without stronger controls Failure is unlikely to be detected before escape

A few habits keep the scoring honest:

  • Score the effect, not the irritation. A nuisance jam can be frustrating but still low severity if it never escapes and recovery is fast.
  • Score current conditions only. Planned sensors, future software updates, and “we should add an interlock” do not count yet.
  • Score detection based on timing and response. A fault message after the bad part leaves the station is weak detection. So is an alarm that operators routinely acknowledge without checking root cause.
  • Use the best evidence available, even if it is incomplete. Maintenance logs, scrap tags, changeover notes, technician memory, and short-term observation are all usable inputs when formal failure history is thin.

That last point matters in automation projects. Many plants delay FMEA because they believe the team needs perfect data to justify the scores. In practice, launch teams and retrofit teams rarely have that luxury. A disciplined estimate from experienced operators, technicians, and engineers is usually better than waiting six months to collect cleaner history while the process keeps losing time and making defects.

Some organizations now rank actions with action-priority methods instead of relying only on raw RPN. That can help, especially when high-severity items deserve attention even if occurrence is low. For many operations managers, though, classic RPN is still the fastest way to sort a long list into an action plan the plant can execute.

Identifying Common Failure Modes in Automated Systems

A blank worksheet slows teams down because people know problems exist, but they don't know where to start naming them. In semi-automated systems, recurring failure patterns tend to show up in the same places: interfaces, handoffs, timing assumptions, part variation, and operator interaction.

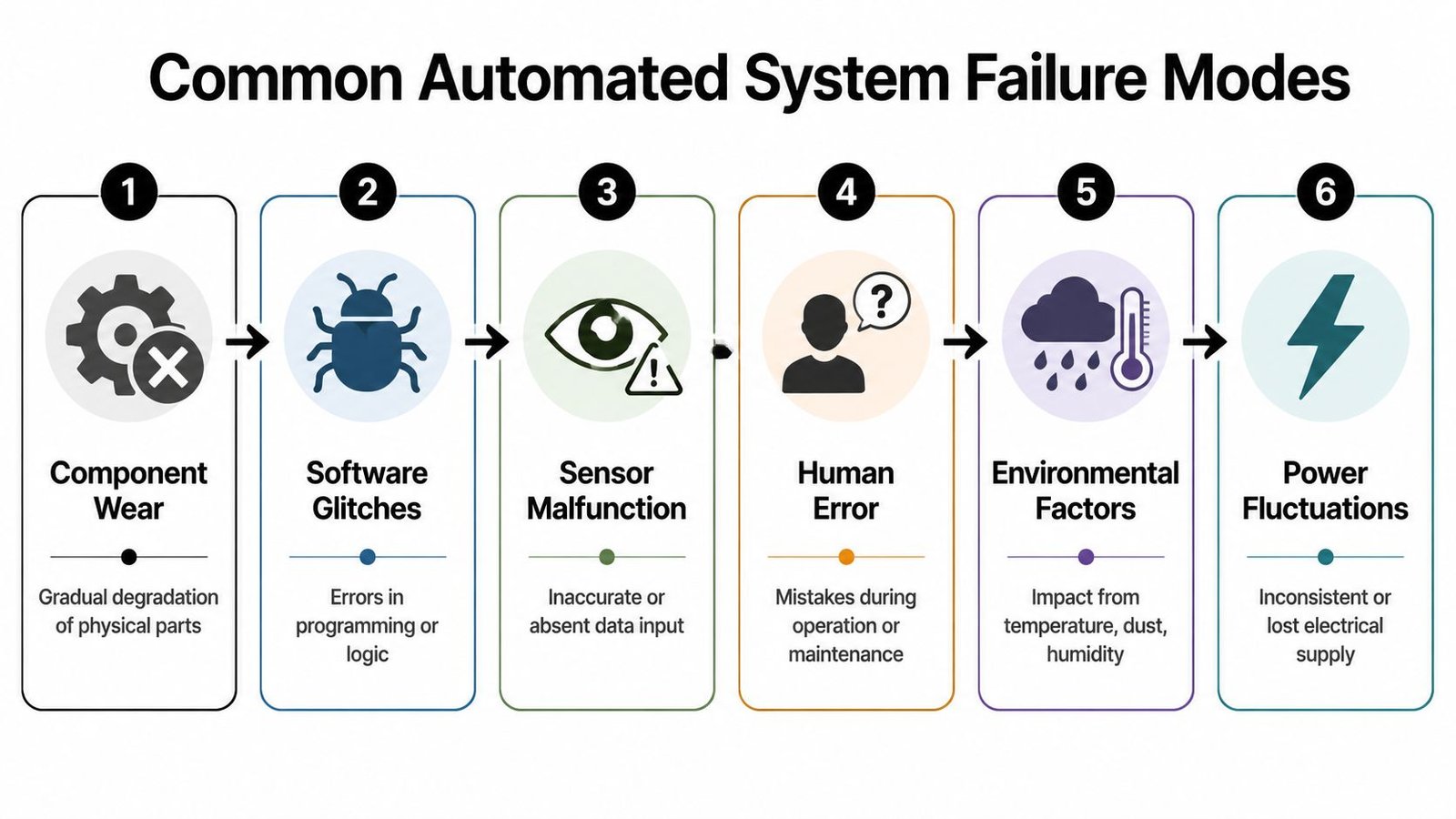

A diagram listing six common automated system failure modes including component wear, software glitches, and human error.

Failure patterns that show up often

A practical review usually starts with six categories.

Failure area What it looks like on the floor
Component wear Worn nests, bits, seals, slides, or grippers create drift and intermittent quality loss
Software glitches PLC sequence faults, incorrect interlocks, timer assumptions, or recipe mismatches cause inconsistent behavior
Sensor malfunction False positives, missed reads, contamination, poor mounting, or tolerance stack-up disrupt station logic
Human error Wrong part loaded, bypassed checks, poor changeover, or inconsistent setup creates avoidable variation
Environmental factors Dust, lighting, vibration, humidity, or temperature change affects detection and repeatability
Power fluctuations Resets, communication faults, brownout behavior, or device instability interrupt the process

Those categories are broad enough to prompt discussion and specific enough to lead to action.

Take sensor malfunction. On paper it sounds simple. On the line it can mean part-present photoeyes that work during debug but fail when reflective surfaces change, inductive sensors mounted too far from the target, or vision checks that become unstable when ambient light shifts after maintenance leaves a panel open.

Take human error. In semi-automated systems, this often isn't a training problem alone. It's a design problem. If the fixture allows the wrong orientation, if the HMI sequence isn't clear, or if recovery steps are confusing after a jam, the process is inviting the mistake.

When operators make the same “mistake” more than once, the first question should be whether the process made the wrong action too easy.

Use root cause tools to go deeper than symptoms

Once the team lists failure modes, don't stop at the first explanation. “Sensor failed” and “operator missed step” are usually symptoms, not root causes.

Root cause work inside FMEA commonly uses three practical tools: the 5 Whys to trace causal chains, the Fishbone (Ishikawa) diagram using the 8Ms of Man, Machine, Material, Method, Measurement, Mother Nature, Management, and Maintenance, and Fault Tree Analysis to model combinations of events, according to Fresh Consulting's explanation of FMEA root cause methods.

A simple example helps:

Failure mode: Part jams before pressing operation
Symptom-level cause: Feeder presented part incorrectly

Use the 5 Whys and you may uncover any of these:

  1. Part presented incorrectly.
  2. Guide rails allow tilt on one part family.
  3. Rail adjustment depends on manual setup.
  4. No positive locator exists for changeover.
  5. Tooling was designed for flexibility but not repeatable setup.

That chain points to a very different action than “tell operators to be careful.”

The Fishbone approach is especially useful when the problem crosses disciplines:

  • Machine: worn escapement, sticky cylinder, weak clamping
  • Material: burrs, dimension variation, surface finish issues
  • Method: poor setup sequence, vague work instruction
  • Measurement: no in-process check for presentation error
  • Maintenance: lubrication interval not defined
  • Mother Nature: dust or temperature affecting sensor reliability

The value of failure mode analysis isn't that it identifies every possible failure. It's that it helps the team identify the failures that matter most, then understand them well enough to remove or control them.

From Analysis to Action Planning Your Mitigation

The FMEA worksheet is only useful when it drives a change on the floor. If a feeder still misloads parts, a station still faults twice a shift, or a quality escape still reaches final inspection, the team has analysis but not risk reduction.

Start with the items at the top of your ranking method and force each one into an action decision. Ask a hard question: What physical change, process change, or control change will reduce severity, lower occurrence, or improve detection? If the answer is “train the operator” or “watch it more closely,” keep working. Those steps may support a fix, but they rarely remove the risk in a semi-automated process.

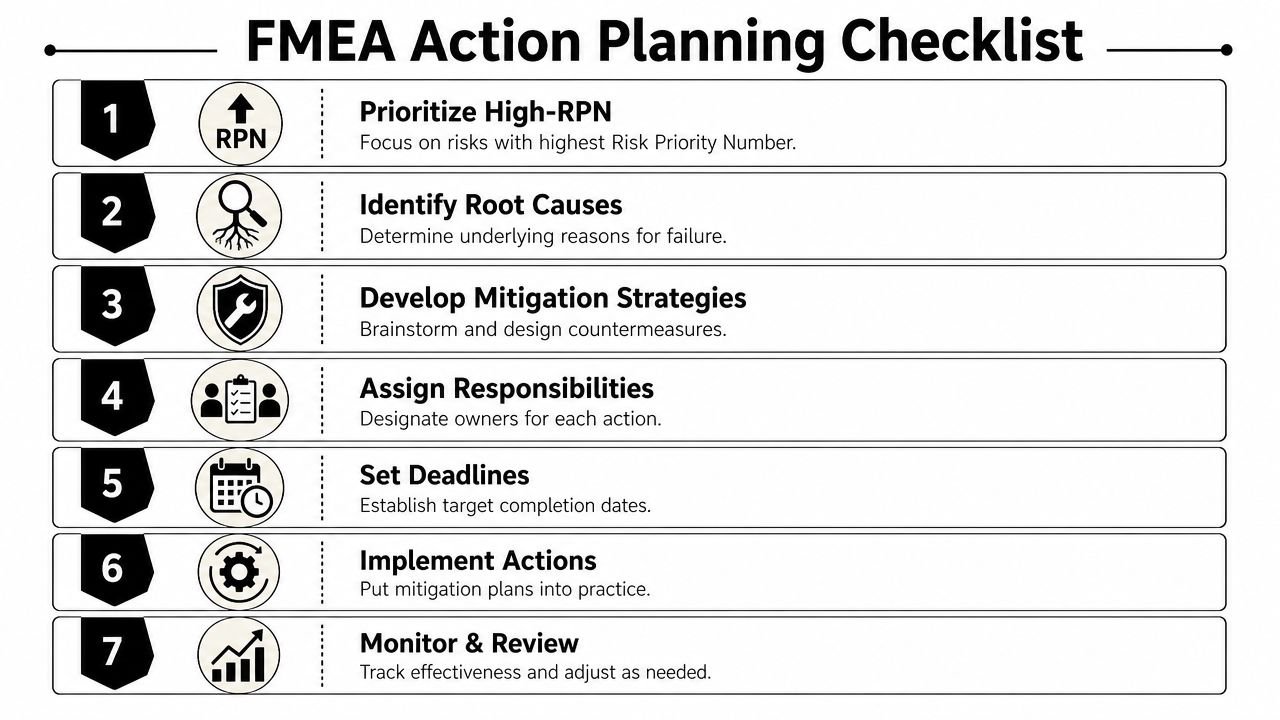

A seven-step checklist for FMEA action planning, detailing the process from prioritizing risks to monitoring effectiveness.

Choose actions that change the process

Strong mitigation usually falls into three categories, and the order matters. Prevention beats reliance on operator attention. Detection helps, but only after the process has already drifted toward failure.

  1. Prevent the failure

    • Redesign a nest so the part cannot seat incorrectly.
    • Add hard stops, guides, or compliant tooling that absorbs part variation.
    • Simplify a PLC sequence that depends on narrow timing windows.
  2. Reduce the chance it occurs

    • Tighten setup methods and define the adjustment point.
    • Standardize changeover with fixed references instead of manual judgment.
    • Replace subjective checks with torque verification, recipe control, or mechanical limits.
  3. Improve detection before escape

    • Add presence sensing, torque confirmation, barcode validation, or vision checks.
    • Improve HMI fault messages so the response is clear under production pressure.
    • Add an interlock that blocks cycle start when a prerequisite is missing.

Mistake-proofing often gives the best return because it removes the decision that causes the defect. A well-designed poka-yoke manufacturing method usually does more than another inspection step, especially on stations where one operator supports multiple semi-automated tasks.

That trade-off matters. Extra sensors, vision tools, and interlocks can improve detection, but they also add cost, maintenance load, and nuisance stops if the design is sloppy. In many cells, a simple fixture change or positive locator does more to protect uptime than a complicated detection package.

A good action list is specific enough that maintenance, controls, and production all know what success looks like:

  • The exact failure mode being addressed
  • The proposed countermeasure
  • The owner
  • The completion target
  • The verification method
  • The rescoring requirement after implementation

A short technical walkthrough can help teams visualize how this becomes a repeatable workflow:

Close the loop and rescore

Plants skip this step all the time. The team installs a sensor, revises tooling, updates code, or changes a work instruction, then marks the item complete without proving the result under normal production conditions.

Verification needs to happen on the actual process, with real parts, normal operators, and routine changeovers. For semi-automated systems, that is especially important because many failures only show up during handoff points between person and machine. A safeguard that works during engineering run-off can still fail on second shift if it slows recovery, creates false trips, or depends on perfect loading technique.

After implementation, rescore the item using the same criteria used in the original FMEA. Severity often stays the same unless the design itself changed. Occurrence and detection are usually where teams earn the reduction. If the ranking does not improve enough, the action was incomplete or aimed at the wrong cause.

The best mitigation is the one that still holds up on second shift, after changeover, with normal production variation.

This discipline also helps justify automation spending when historical failure data is thin. Operations leaders do not always have months of stop codes and scrap trends before a retrofit or new station is approved. A well-built FMEA, tied to verified actions and rescoring, gives the team a practical way to compare options, document assumptions, and reduce the risk of buying automation that looks good on paper but struggles in daily production.

Making FMEA a Sustainable Part of Your Culture

A plant usually finds out whether FMEA is part of the culture during an ugly week. A line starts missing output after a tooling change, operators build workarounds to keep parts moving, maintenance clears the same fault twice a shift, and the analysis on file still reflects conditions from commissioning. At that point, the problem is not the worksheet. The problem is that nobody treated it as part of how the operation runs.

Sustained use starts when the FMEA becomes a controlled operating record instead of a launch document. Update it when the fixture changes. Update it when resin, packaging, sensors, software logic, or operator sequence changes. Update it when a semi-automated station develops a repeating stop at the handoff between person and machine, because those are the failures that often slip past planning and erode output.

The plants that keep FMEA useful usually tie it to triggers already built into production and engineering routines:

  • New equipment or tooling release
  • Process changes or line balancing
  • Quality escapes or recurring deviations
  • Major maintenance changes
  • Automation upgrades on manual or semi-automatic stations

Teams also need clear rules for when to use FMEA and when to use RCFA. FMEA asks what could fail under expected operating conditions, especially before a launch, retrofit, or process change. RCFA examines what already failed and why. Both matter. Trouble starts when a plant waits for a breakdown, fills out an FMEA afterward, and treats that paperwork as preventive work.

This matters even more in semi-automated production, where historical data is often thin or misleading. A manual station being upgraded to partial automation may not have clean stop-code history. A new assembly cell may not have enough production hours to produce stable trends. In those cases, operations leaders still need a disciplined way to judge risk, compare concepts, and justify spending. Good FMEA work gives them that. It captures assumptions, exposes weak handoff points, and shows where a modest control change can prevent a far more expensive downtime or quality event later.

Used well, FMEA changes how automation decisions get made. Teams stop buying around feature lists and start reviewing recovery time, fault clarity, maintainability, detection method, and operator error tolerance. That is how plants get equipment that runs on second shift, not just equipment that passes a review meeting.

Putting this into practice often starts with the right engineering partner. If you're evaluating a new semi-automated line, upgrading a manual workstation, or trying to reduce downtime and quality risk before the next launch, System Engineering & Automation helps manufacturers design practical, GMP-aware equipment and engineering solutions that fit real production needs. Their team supports everything from concepts and custom tooling to controls, installation, and commissioning, with a focus on improving quality, safety, efficiency, and service across the full production lifecycle.

Previous Post
Next Post

Leave a Reply

Your email address will not be published. Required fields are marked *

Jessie Ayala

Mr. Ayala holds a degree in mechanical engineering and is a certified tool and die maker, which uniquely equips him to handle even the most complex and customized equipment requirements.

Latest Posts

  • All Posts
  • Automation Insights
  • Automation Solutions
  • Cost-Efficient Engineering
  • Custom Engineering Solutions
  • Engineering Consulting
  • Engineering Solutions
  • Manufacturing Equipment
  • Process Innovation & Modernization
  • Purpose-Driven Engineering
  • Strategic Manufacturing Solutions
    •   Back
    • Real-World Engineering Success
    • Operational Excellence & Efficiency
Load More

End of Content.

Innovation Within Reach

Innovation doesn’t require a million-dollar budget. We work with businesses of all sizes, providing cutting-edge solutions that improve your efficiency and bottom line.

Engineering Solutions that Drive Quality, Efficiency, and Innovation.

© 2025 System Engineering & Automation. All rights reserved.

Join Our Community

We will only send relevant news and no spam

You have been successfully Subscribed! Ops! Something went wrong, please try again.
